May 4, 2026 – PRIO S.A. (“Company” or “PRIO”) (B3: PRIO3), following best practices incorporate governance and transparency, informs its preliminary and non-audited Operational Data for the month of April.

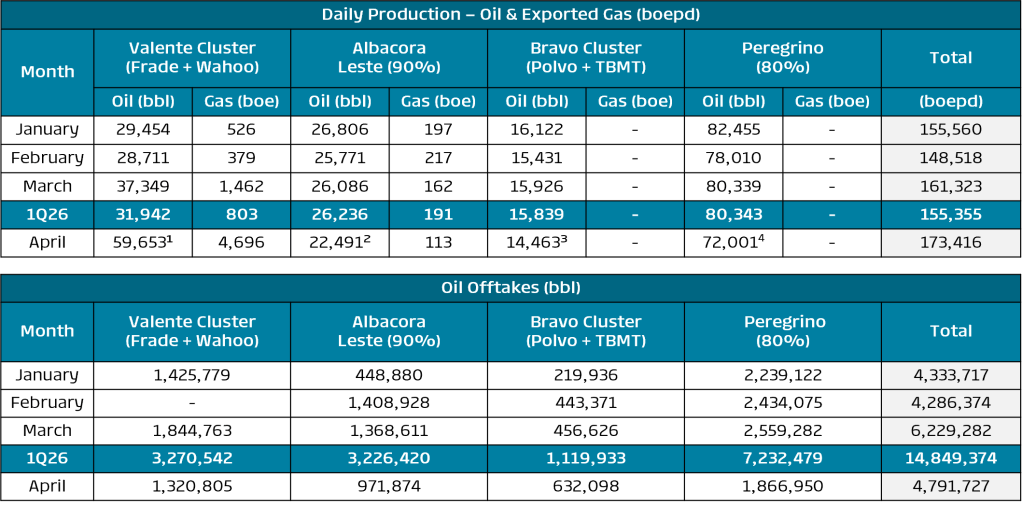

Key:
(1) At the Valente cluster, the third producing well in the Wahoo field began production on April 6. The fourth well is expected to start production by mid-May due to damage to the crane of the vessel responsible for the umbilical installation.
(2) Production at the Albacora Leste field was temporarily impacted by a turbine failure, which has been resolved. Additionally, the well ABL-68 had its production interrupted due to hydrate formation.
(3) At the Bravo cluster, production was affected by the shutdown of the well OGX-44HP due to a Submerged Centrifugal Pump failure, with workover initiated in April and expected to be completed in May. (4) Production at the Peregrino field was impacted by a temporary failure in the multiphase pump on platform C and by the shutdown of the well C-26 due to a Submerged Centrifugal Pump failure, with workover completed at the end of April.
Leave a comment
